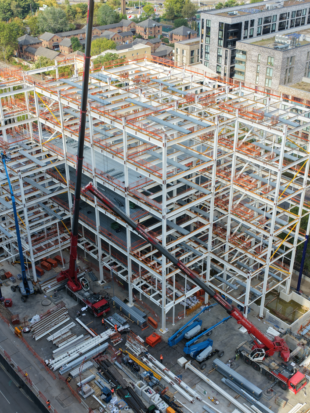

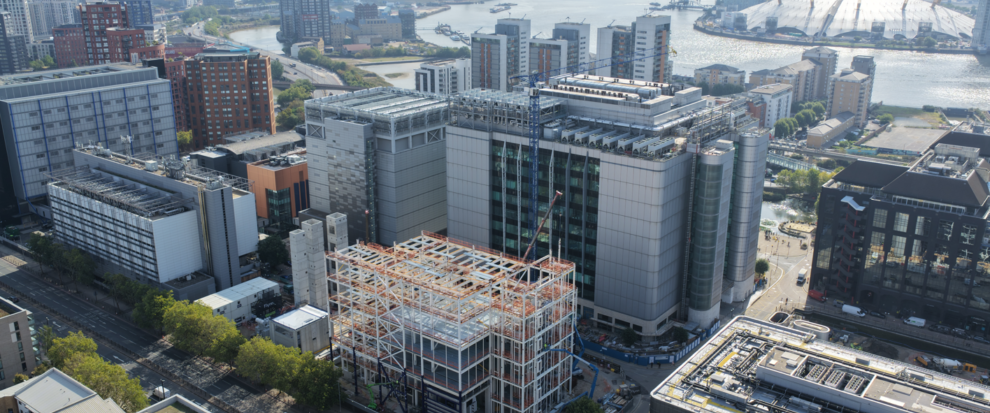

Great progress continues to be made on our Telehouse West 2 project. Two gangs are installing the structural steelwork, with nearly a quarter of all steel stood. Decking us underway, with sectional floors ready for studding from Mezzanine to Level 03. All lift cores have now been stood to L04, awaiting Tower Crane erection to complete. Both 132kV, 103t have been installed on site, with one skated in last week and the second to be skated in on 28th September. Our permanent welfare has now been established on site, with the team continuing to achieve major programme milestones as the superstructure takes shape. Well done to ethe team on site for their hard work and continued progress.
